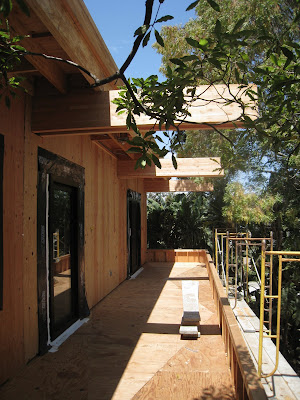

Main House is Framed and all Exterior Sheathing is complete with FSC Plywood Struct 1 Non-UF. 95% of plumbing is in place ( All Hot Lines and returns to recirvulating pump-have been insulated with R-5. 100% of lighting/electrical has been done; 90% of lighting will be ceiling recessed LED's. Rough Framing, Plumbing, and Electrical Inspections to follow. Insulation and Drywall in the next weeks. We have begun installing exterior doors (Recycled Aluminum & Glass (double pane/argon filled). Week after next the windows will be installed. Minor framing inside required for bathroom/ shower dams and tub decks will be finalized this week.
The Garage Concrete pads have been poured. Monday the Structural Steel for the Exterior Staircase will be erected. We have scheduled for Concrete Grade Beams & Foundation to be poured this Friday. All of the lumber for the garage is on standby. I expect Framing for the garage to be complete by mid-August.
